Hedge Road Landing Subdivision in Georgina Faces Creditor Protection Amid Construction Delays

📅 2 days ago
Hedge Road Landing Subdivision in Georgina Faces Creditor Protection Amid Construction Delays

The Hedge Road Landing project in Georgina, Ontario, has entered creditor protection as construction halts due to financial issues and market downturns.

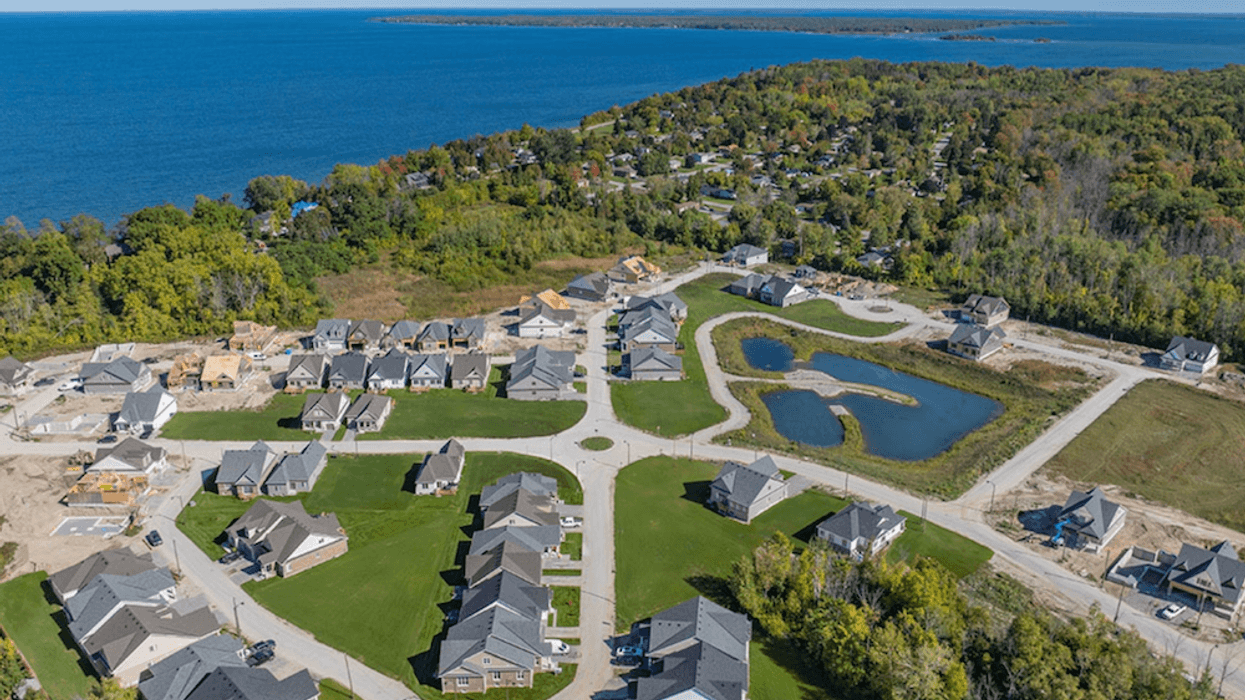

The Hedge Road Landing subdivision project, located in Georgina, Ontario, near the scenic Lake Simcoe, has been placed under creditor protection midway through its construction phase, as reported by the Ontario Superior Court. This development is structured in three phases, with Phase One situated at 6213 Black River Road, featuring a total of 144 cottage-style bungalow homes designed for an adult active lifestyle community.
As per court documents, the current status of Phase One shows that 75 units have been completed and sold, while 24 units are under construction, with 23 of those already pre-sold. Additionally, there are 45 units yet to commence construction, of which 13 have also been pre-sold. The remaining two phases of the project will be developed on adjacent vacant land, aiming to include another 168 units along the picturesque waterfront of Lake Simcoe.
The project is managed by 2055226 Ontario Inc., which is owned equally by three parties: Alliance (Sutton) Inc., Berkstar Developments Inc., and Rose Sutton Limited Partnership. Alliance Homes has taken on the role of construction manager for this ambitious project. Financing for the development has been sourced from MarshallZehr, a non-bank real estate lender based in Waterloo, which provided a principal loan of $48,553,000 for Phase One and an additional loan amounting to $16,050,000 for the subsequent phases.
However, the financial landscape has turned challenging, as both loans matured on January 1 and March 1, 2026, respectively, without repayment. As of August 13, MarshallZehr reported that they are owed a total of $42,907,636.19, with interest still accruing. The developers have also struggled to meet their financial obligations to contractors and suppliers, resulting in seven liens totaling $5.7 million being filed against the Phase One property since February.
The court-appointed Monitor has indicated that these construction liens have significantly hindered the resumption of construction activities at the project. "Construction activities have largely ceased since April 2026," noted the Monitor in their report accompanying MarshallZehr’s creditor protection application. They also warned that the ongoing delays increase costs and could negatively impact the project’s value.
In an affidavit dated August 17, Alliance Homes’ President Alex Troop attributed the project’s difficulties to a downturn in the Greater Toronto Area (GTA) real estate market, which has led to reduced land values and a decline in new home sales. Troop stated, "205 has not sold a new home since January of 2025, which has affected cash flow and the ability to finance construction for units already under contract." The last closing of a house sale was recorded on March 31, 2026.
Concerns have also been raised by some purchasers to the Home Construction Regulatory Authority (HCRA), which is currently reviewing the issues. Troop expressed worries that the warranty provider, Tarion, might take actions that could further jeopardize the project. He mentioned that he has personally contributed $600,000 towards the project but is unable to continue this financial support.
On August 24, the Ontario Superior Court granted MarshallZehr's application for creditor protection under the federal Companies’ Creditors Arrangement Act (CCAA), aiming to halt various enforcement actions against the project to facilitate its completion. Currently, there are 10 units in Phase One expected to be completed within the next three months, all of which have been pre-sold.
The Monitor has engaged Daniel Foch of Valery Real Estate to assess the project’s unit values, with Foch suggesting potential price increases of 5% to 10% should the units be remarketed, although the Monitor cautioned that this assessment does not account for possible negative perceptions stemming from the CCAA proceedings.
Recognizing the complexities involved, the Monitor has chosen to proceed with existing presale agreements and has submitted a plan to complete the remaining sales, which received court approval on August 28. Typically, creditor protection applications are granted for an initial period of 10 days, with extensions available as necessary. Following the placement of Hedge Road Landing under creditor protection, the stay of proceedings has been extended to November 13, 2026, when further updates are anticipated.
